SITE VISIT REPORT: EXTERIOR STONE CLADDING PREPARATION AND INTERNAL CERAMIC FLOOR PIPING INTEGRATION
Project Name: Proposed Villa Location: Block G, Plot 549, Mohammed Bin Zayed City (MBZC), Fujairah Date of Visit: June 01, 2026 Time of Visit: 12:00 PM Report Prepared By: Engineer Adeel Arif (Site Engineer)
____________
I. Purpose of Visit:
The main engineering objective of this site inspection was to evaluate the structural readiness of the substructure before transitioning into final finishing stages. This involved conducting a villa plaster finishing quality inspection UAE check on the completed external bitumen repairing work to clear the elevations for architectural stone cladding, inspecting the ongoing internal floor piping installations, and reviewing the material supply chain logistics for incoming ceramic tiles.
II. Observations & Progress Status:
A meticulous technical evaluation across the interior and exterior zones of the villa structural shell revealed the following updates:
- Substructure Waterproofing Repairs: The outside walls bitumen repairing work is in progress and is now almost complete. Minor abrasions, localized pinholes, and cold joint imperfections in the primary waterproofing membrane have been successfully resealed using a high-build rubberized bitumen emulsion, creating a robust, continuous barrier against moisture ingress.

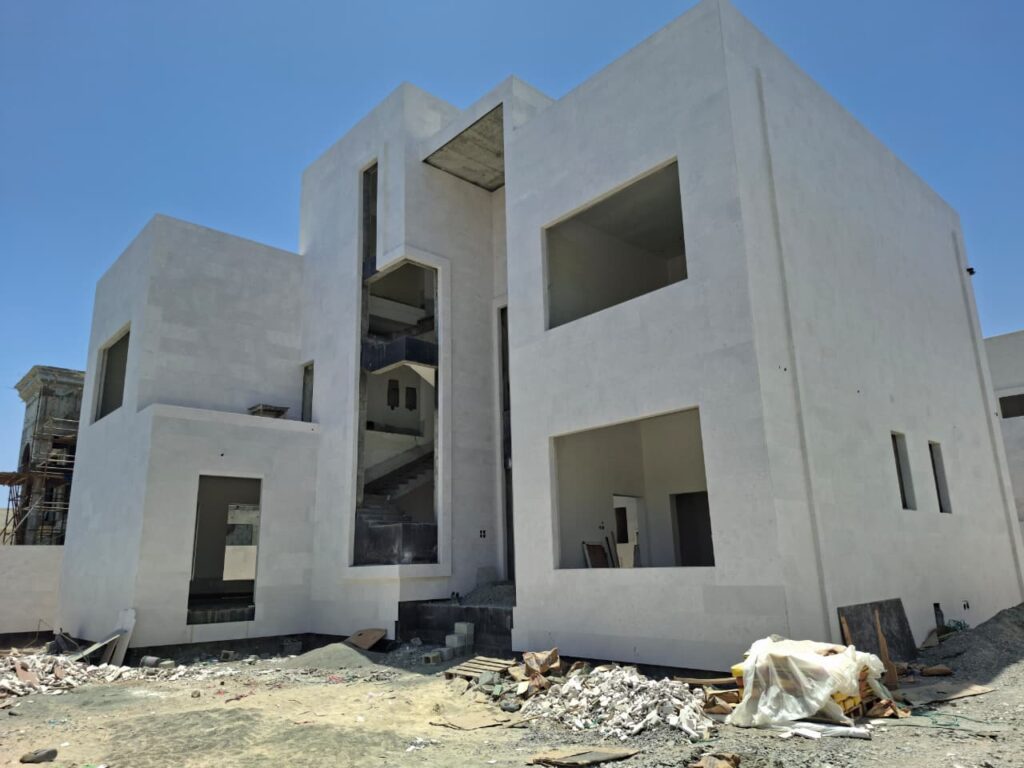

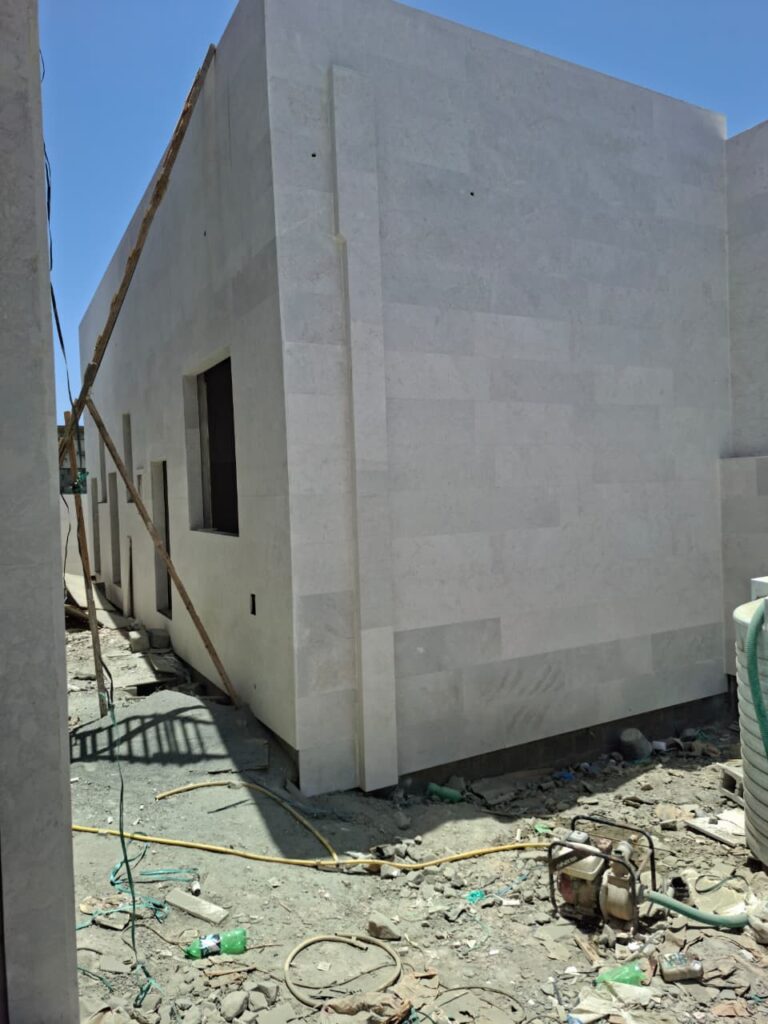

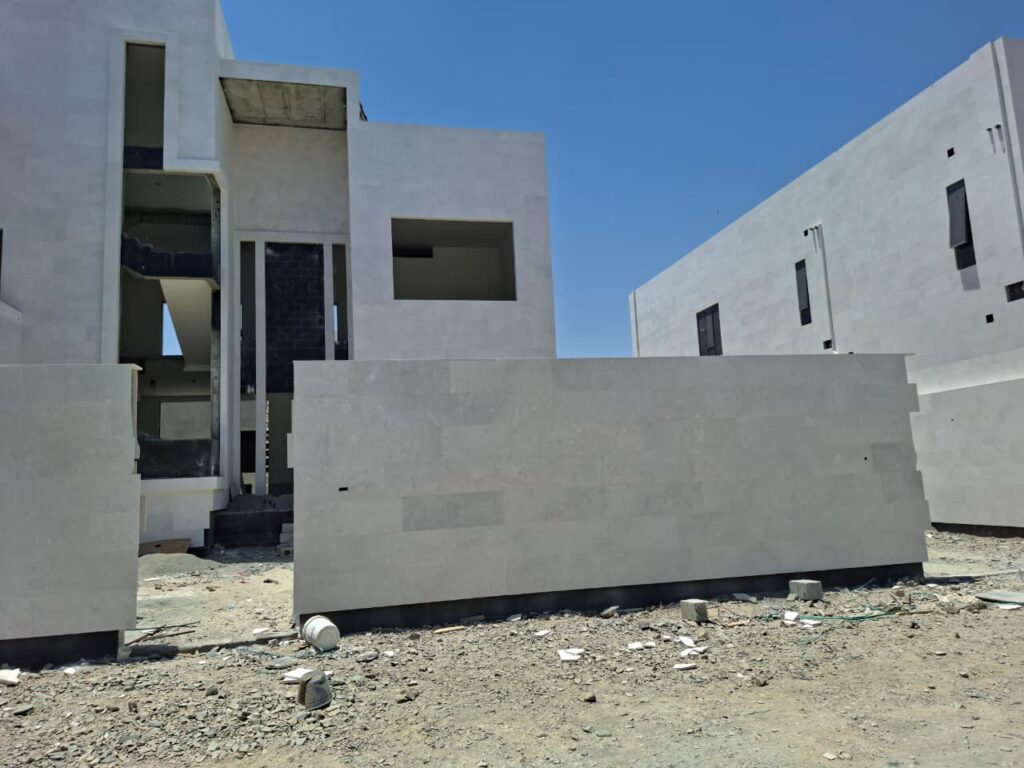

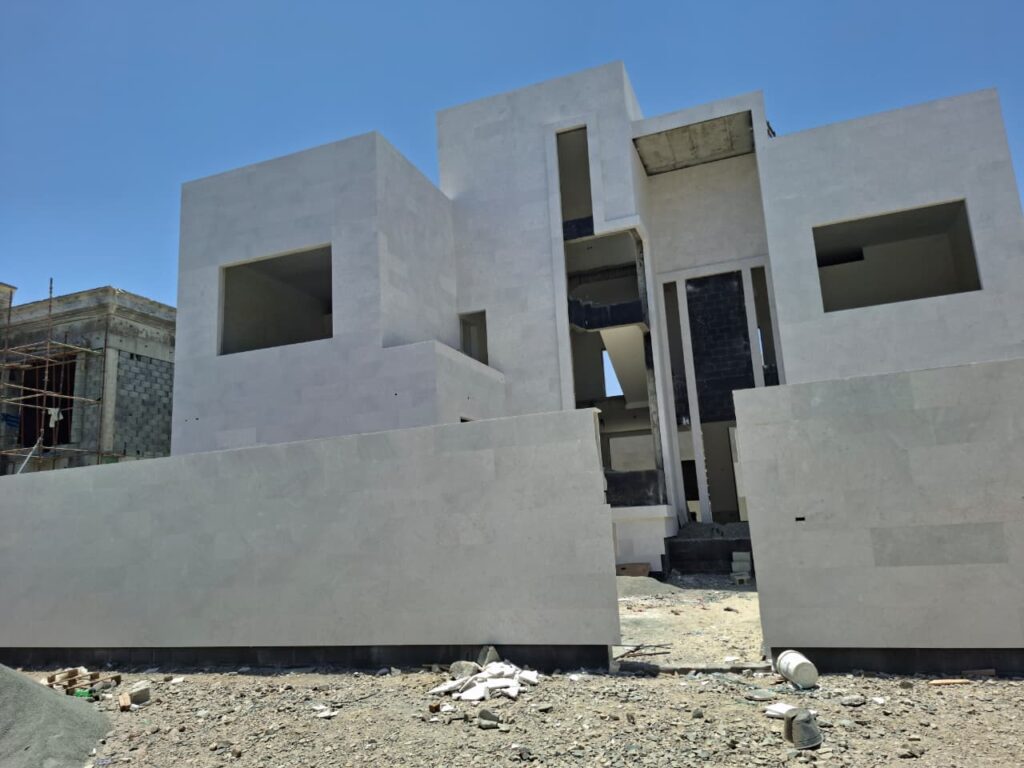

- External Cladding Readiness: With the external waterproofing repairs reaching near-completion, the structural envelope is adequately prepared for decorative finishes. The site is in an optimal condition for the specialized sub-contractor to start the stone works, ensuring stable mechanical or wet-fixing anchorages onto a sound, protected substrate.

- Internal Service Routing: Inside the villa, electrical and public health floor piping is actively in progress. Conduits and pipe networks are being systematically laid out and secured across the subgrade level, ensuring all MEP runs are fully integrated and pressure-tested prior to final floor screeding.

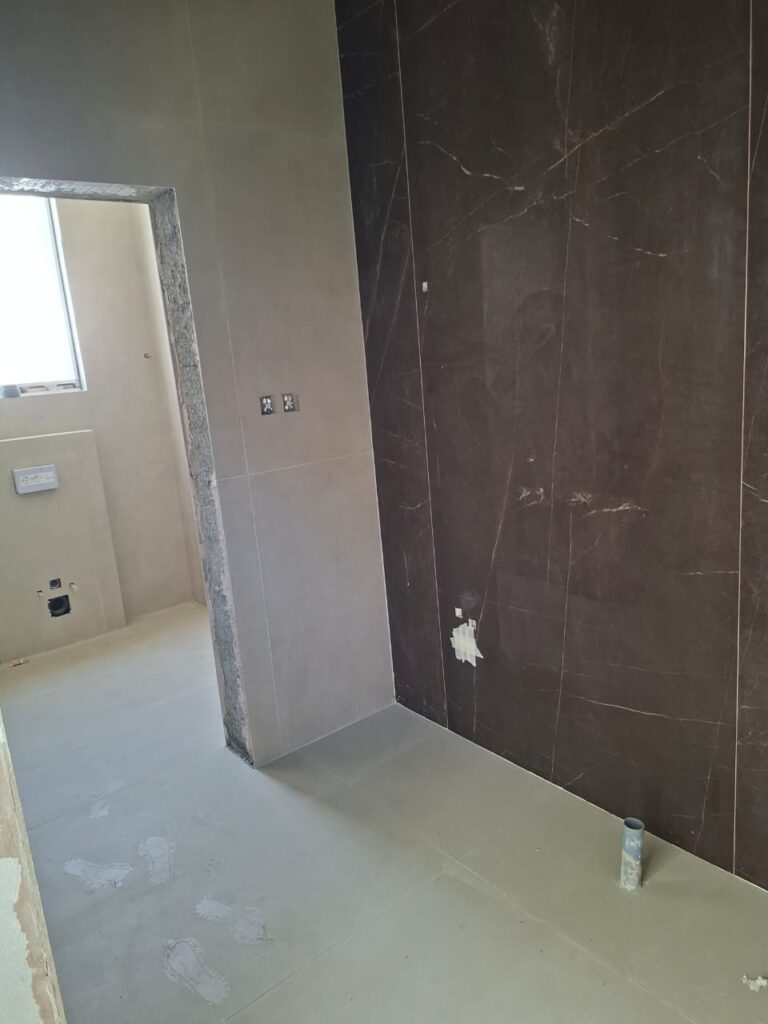

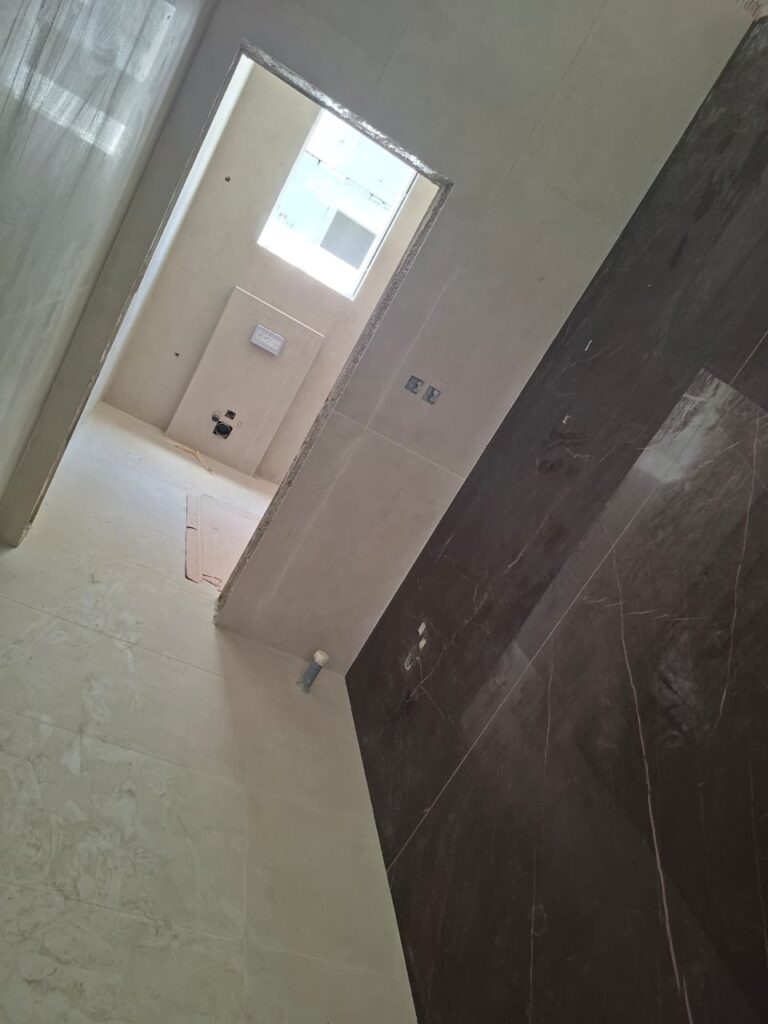

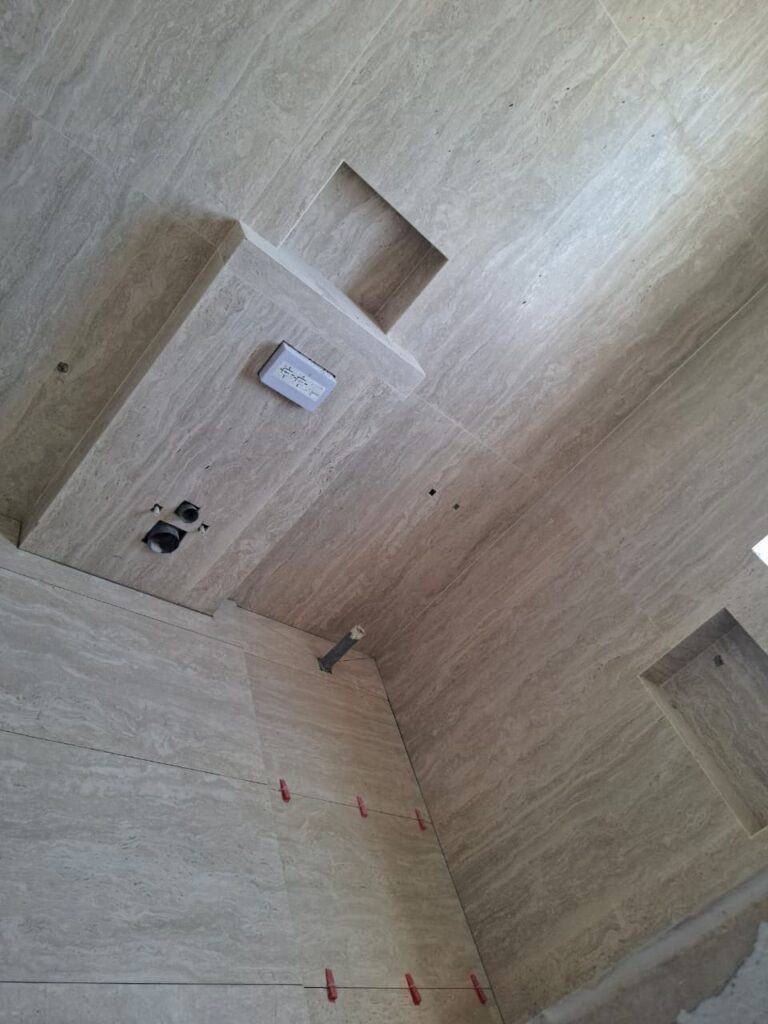

- Tiling Logistics Status: The internal ceramic works are in progress across the designated wet areas. However, the site is currently waiting for ceramic delivery for remaining ceramic modules to complete the large-format floor and wall layouts, which has temporarily restricted the tiling progression to specific localized zones.
- Civil Infrastructure Progress: Externally, the domestic drainage manhole works are almost completed as well. The structural brickwork/concrete rings have been constructed, internal benching is finalized, and pipe connections are aligned, leaving only final cover level adjustments pending.
III. Directives & Next Steps:
To satisfy the strict quality benchmarks mandatory for a high-ranking site engineer report UAE, the following field instructions are issued to the contracting team:
- Sub-Contractor Coordination for Cladding: Coordinate immediately with the stone works sub-contractor to finalize layout lines and anchor points on the outside walls, ensuring no mechanical anchors compromise the newly repaired bitumen waterproofing layer.
- Material Tracking and Procurement: Follow up aggressively on the pending ceramic delivery for remaining ceramic consignments to avoid any idle labor on-site and ensure continuity between wall cladding and ground floor tiling works.
- Conduit Protection and Capping: Ensure all exposed ends of the floor piping and electrical conduits are tightly capped or plugged to prevent the ingress of cement slurry, dust, or debris during ongoing masonry and upcoming screed pours.
- Manhole Testing and Backfilling: Conduct mandatory water tightness or smoke testing on the almost completed manholes before performing final backfilling around the chambers using approved, compacted granular fill materials.
IV. Concluding Remarks:
The villa construction in UAE is moving forward at an engineering-sound pace, with wet structural trades successfully giving way to specialized architectural finishes. The near-completion of external bitumen repairs and manhole infrastructure provides an excellent hand-over window for exterior stone works. Once the pending ceramic material delivery is resolved, the internal finishing phase will achieve full production momentum.
For previous report click here.
